Activities during pipelay operation offshore.

Here is the list of activities during pipelay installation. Assume laying pipe from an existing platform to another existing platform. Conventional 8 point mooring derrick lay barge (DLB) is utilized to execute the job.
- Temporarily drop anchor outside field. Wait for clearance form platform to start operations. Some client might require contractor to brief the platform management on their activities prior start up.
- Meanwhile waiting for clearance, ensure all preparation to start lay pipe is ready.
- Install stinger
- Prepare tunnel to lay pipe.
- Rig up welding machine.
- Tensioner shoes are set up to accommodate pipe size.

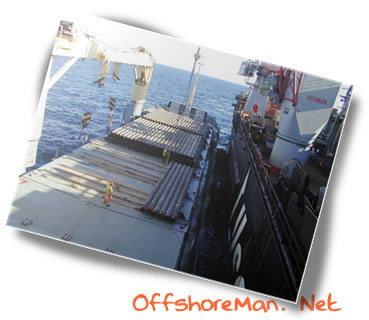

- Bring along side transportation barge and start transfer as much line pipe to barge deck to fill up tunnel for start up.
- Ensure end preparation machine & swabbing rabbit for cleaning is ready in place.
- Prepare pipeline internal equipment, i.e. buckle detector, X-ray crawler.
- Ensure firing stations and other stations are ready to lay pipe.
- Fill up tunnel with appropriate line pipe (Check wall & concrete thickness)
- Well start-up head. Start-up head should filled with PIG (Pipeline Internal Gauging)
- Upon receiving confirmation to start work, perform anchor running operations. Set up barge as per approved anchor pattern.
- Start-up pipelay. 2 common methods to start laying pipe. i.e. Deadman anchor or Bow string attached to jacket leg.
- Lay pipe slowly until pipestring touch down to seabed.
- Slowly pick up speed on pipelay and lay away until the final destination.
- Common activities during layaway.
- Interval check of stinger condition by ROV & air diver.
- Profile check by ROV.
- Barge will dynamically crawl in an approved anchor pattern.
- Survey to ensure barge is always in the right direction and properly record the pipeline asbuilt route.
- QA/QC to ensure welding & NDT activities are as per approved procedure.
- Safety officer to ensure all procedure & precautions are taken for safe operations.
- Maintain communication, good record & reporting to onshore head office.
- Sometimes contractor might encounter Cable or pipeline crossings.
The above notes is open for discussion, I might miss some important activities. Readers are invited to share experience and knowledge. Next time, I’ll write about laydown activities.
| Posted by : Sulaiman Sabur | |
| Biography : Author (also the WebMaster) hold a degree in Mechanical Engineering from University of Malaya. He has extensive experience in offshore construction and currently employed by one of the Major Offshore Construction Company in Malaysia. |
How to post your own article << Click Here !
One Response to 'Activities during pipelay operation offshore.'
Websites Linked to this Article
Leave a Reply
![]() SUBSCRIBE to Latest Posts by EmailYour email is safe from spam. All emails will be handled by FeedBurner a Google Company. Subscribe Safely NOW |

on 8th, April
Dear suleiman
Do you have any picture regarding pipelay start-up from a jacket?
should jacket design for bow string attachment before in engineering stage?
